Forces need a
continuous route.

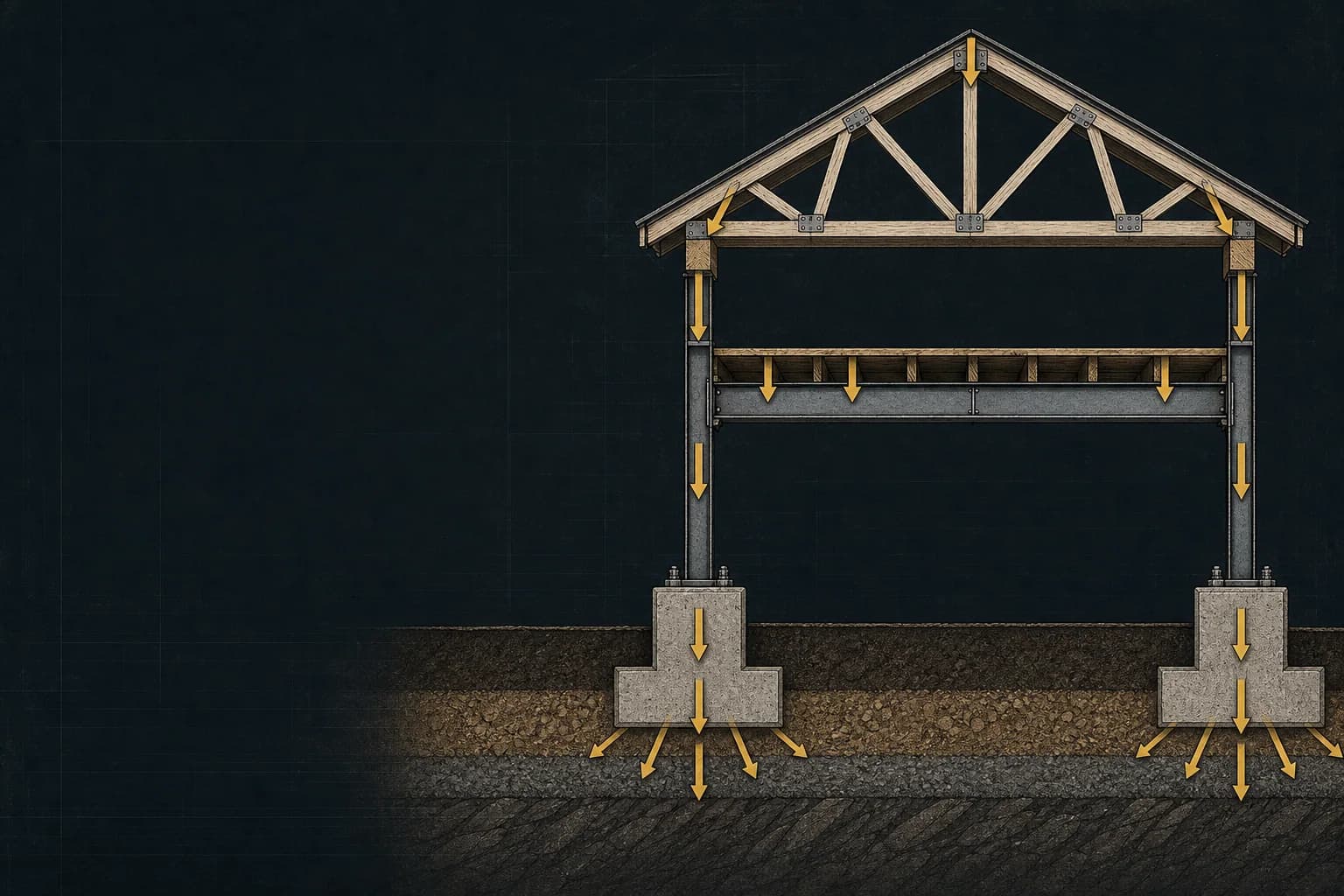

A roof load may pass through a truss, bearing wall, floor, beam, column, footing, and finally soil. One missing connection breaks the path.
Construction knowledge, clearly built
A visual fieldbook for students: follow a project from first brief to handover, understand the systems inside every detail, and meet the people who make it happen.

The logic is already there.

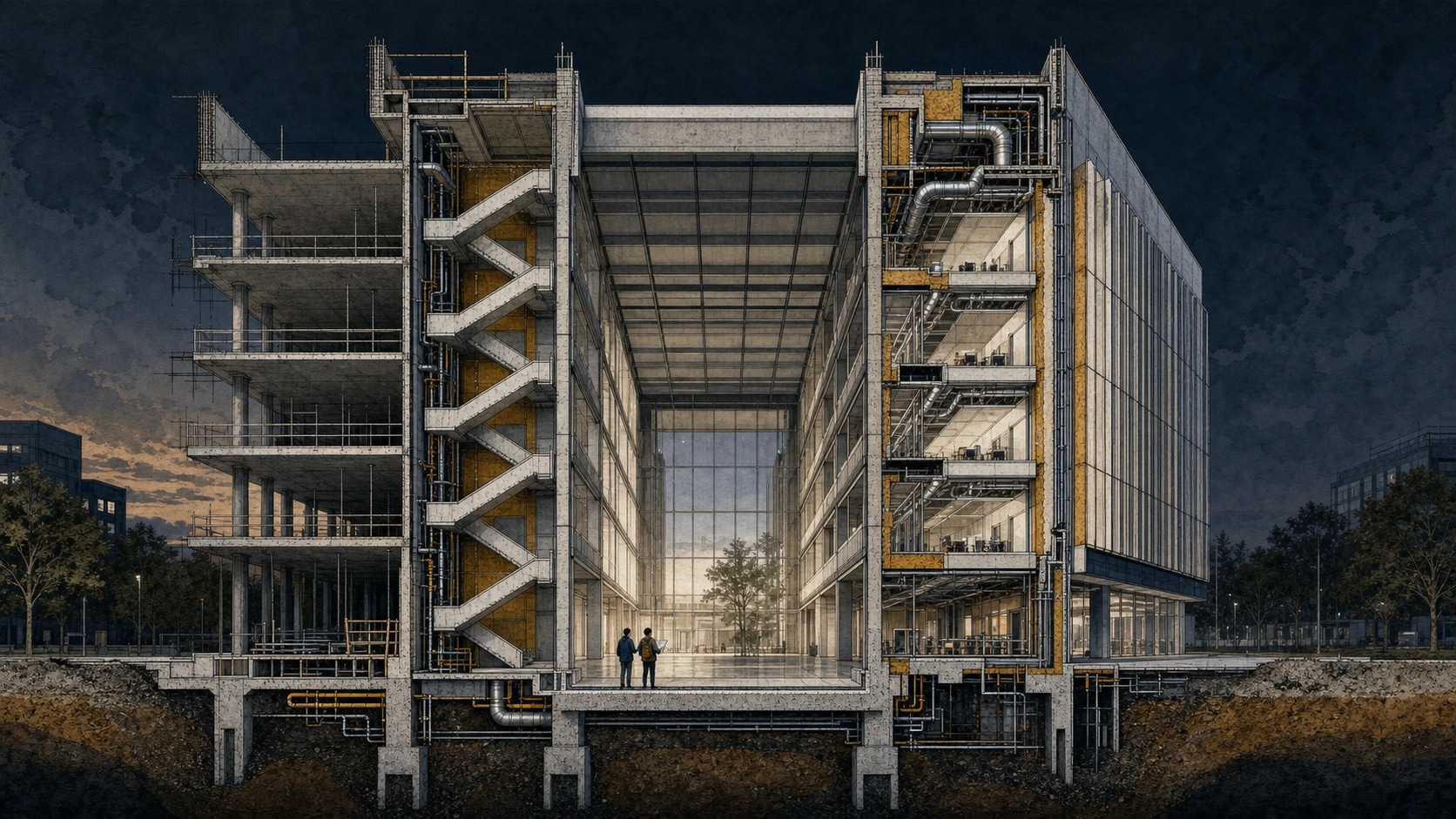

Understand the whole building
Use four habits on every drawing and site visit: trace forces, follow water, preserve control layers, and check the sequence of work.

A roof load may pass through a truss, bearing wall, floor, beam, column, footing, and finally soil. One missing connection breaks the path.

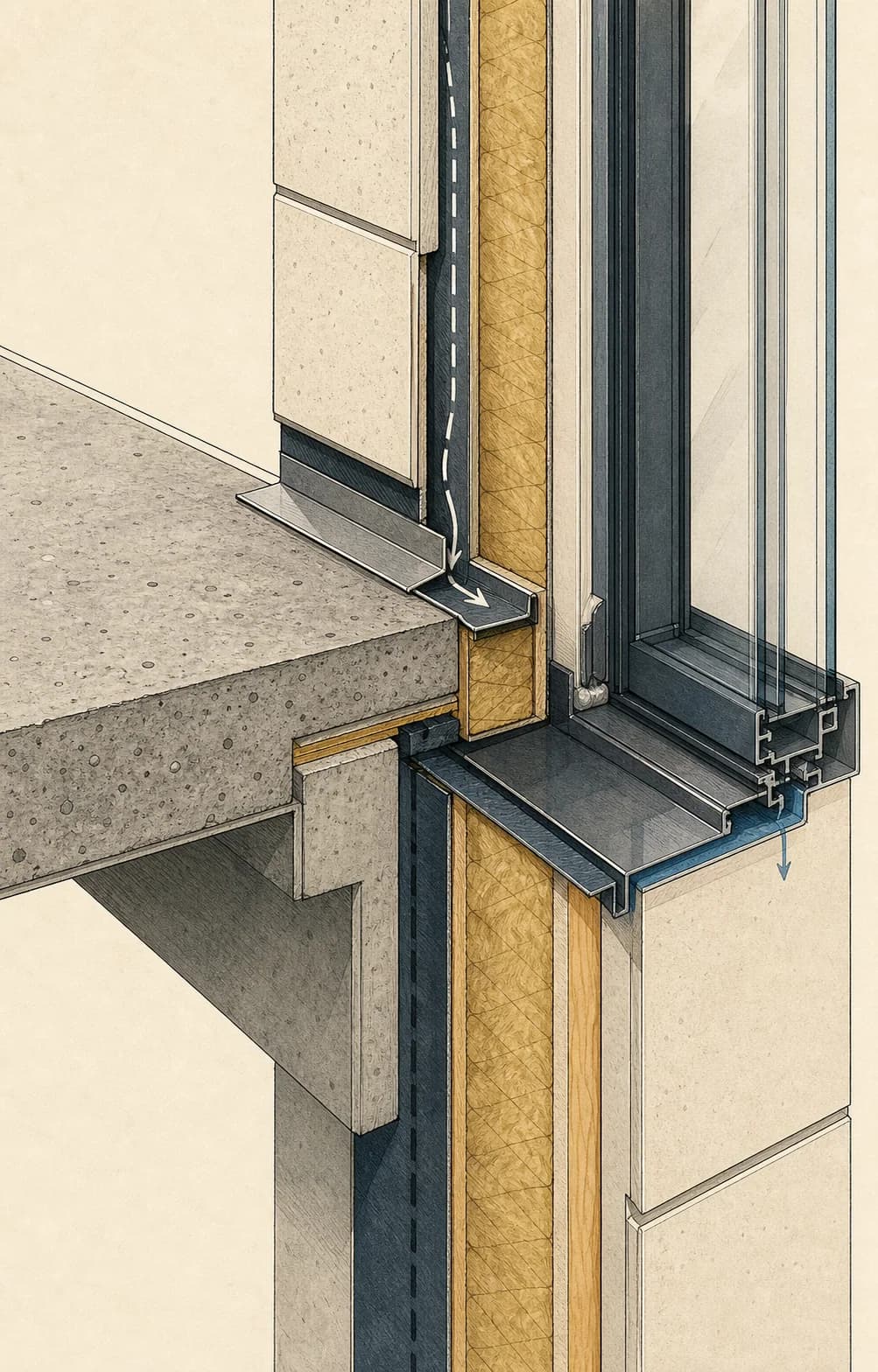

Insulation, air barriers, and waterproofing perform only when joints, corners, and penetrations stay connected.

A correct detail can still fail if the installer cannot reach it, inspect it, or protect it before the next trade arrives.
The complete sequence
Real projects overlap and procurement routes differ, but this sequence gives students a reliable mental map of the work.
Commission boundary and topographic surveys, utility searches, geotechnical investigation, environmental studies, and an initial code review. Define occupancy, area schedules, design life, structural actions, fire assumptions, energy targets, budget, programme, and risk allowances.
Do not freeze the concept until survey gaps, ground risk, approval route, utility capacity, and major cost exclusions are recorded.
Project brief, surveys, geotechnical report, feasibility estimate, outline programme, constraints map, and risk register.
Client, architect, cost consultant
Fix grids and levels, develop the structural load path and foundation concept, size primary plant and distribution routes, define compartments and escape paths, and detail water, air, vapour, and thermal control layers. Coordinate openings, sleeves, tolerances, access zones, falls, maintenance clearances, and temporary conditions.
Issue construction information only after discipline sign-off, clash closure, design-change control, and confirmation that critical details can be inspected and built.
Coordinated drawings or model, calculations, specifications, schedules, design-risk register, and issue register.
Architect, engineers, BIM coordinator
Obtain required permissions, divide the design into tender and trade packages, define performance requirements, inspection and test plans, submittal procedures, temporary-works responsibility, logistics, and commissioning duties. Compare tenders on scope as well as price and identify long-lead materials, plant, and specialist fabrication.
Do not mobilise a work package without the required approval, signed scope, current drawings, agreed quality plan, safe method, and named design responsibility.
Approvals, contract documents, responsibility matrix, baseline programme, procurement schedule, submittal register, and inspection and test plans.
Planning team, building control, quantity surveyor
Establish protected survey control, hoarding, access, lifting and storage zones, welfare, temporary power and drainage. Scan and expose utilities, strip unsuitable material, excavate with designed slopes, shoring or trench protection, control groundwater, prepare formation, place engineered fill in layers, and install below-ground drainage to surveyed inverts.
Do not place blinding, foundations, or backfill until formation, buried services, drainage tests, levels, and protective systems have been inspected and recorded.
Setting-out survey, permits to dig, excavation inspections, compaction results, drainage tests, survey coordinates, and concealed-work photographs.
Site manager, surveyor, civil contractor
Install piles, pads, strips or raft foundations, pile caps, ground beams, retaining walls, below-ground waterproofing, drainage, earthing, service entries, and ground slabs. Coordinate reinforcement, laps, couplers, cover, waterstops, cast-in items, sleeves, construction joints, concrete placement sequence, curing, and backfill loading.
No concrete pour before the pre-pour inspection is released. Do not strip support or load the element until specified strength and stability conditions are met.
Pile logs, pre-pour checklists, pour cards, concrete tickets, test results, waterproofing inspections, surveys, and nonconformance closures.
Structural engineer, groundworker, concrete team
Sequence cores, columns, walls, beams, slabs, stairs, roof framing, precast units, and load-bearing masonry. Maintain temporary bracing and reshoring, control erection loads, coordinate cast-in plates and openings, and complete bolted, welded, grouted, or reinforced connections in the specified order.
Do not remove temporary bracing, props, or reshoring until the engineer confirms the permanent stability system and required material strength are available.
Erection surveys, connection inspections, bolt and weld records, concrete-strength results, lifting plans, temporary-works checks, and closed nonconformances.
Engineer, frame contractor, lifting team

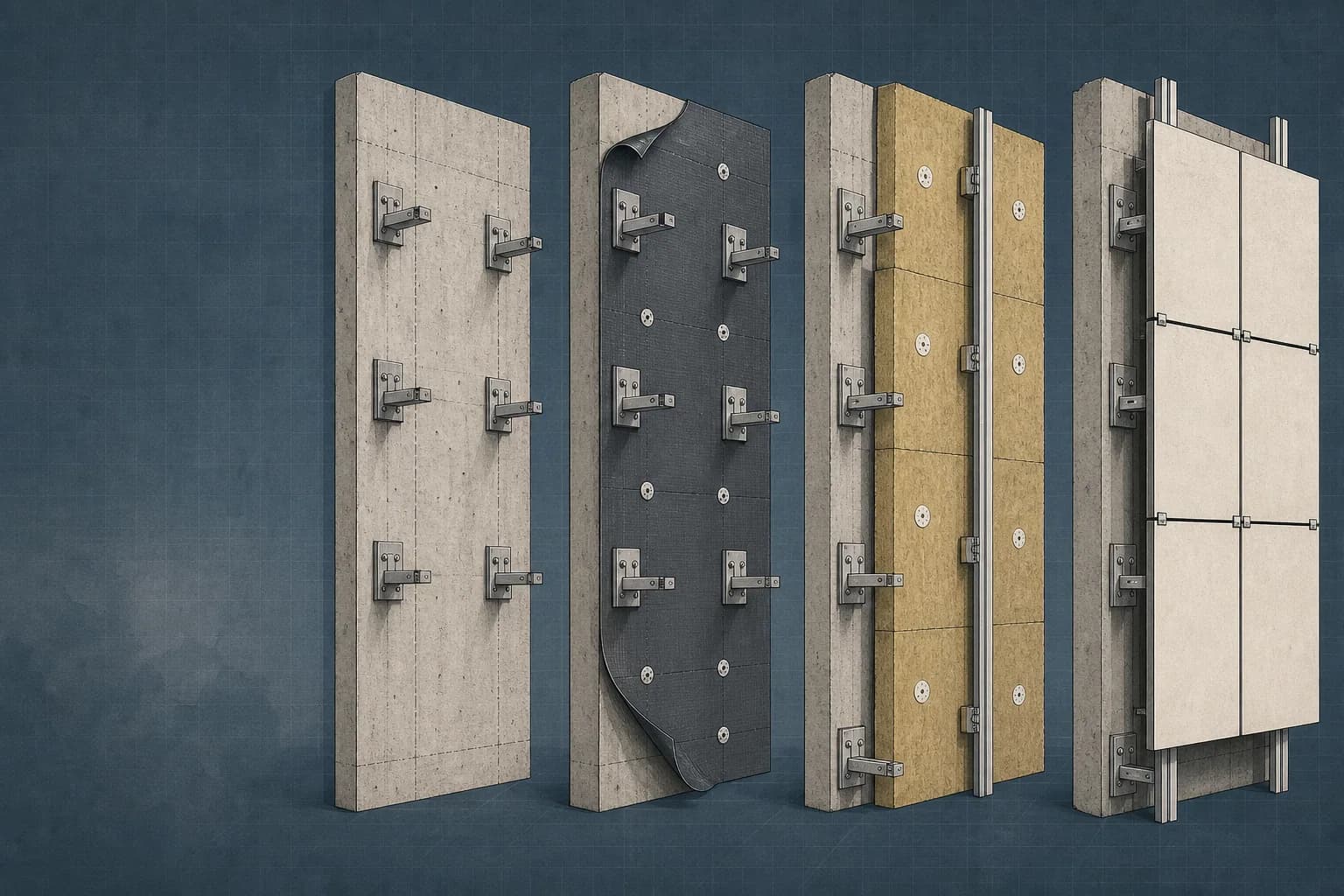

Prepare substrates and install roofs, façades, windows, doors, membranes, air barriers, vapour-control layers, insulation, cavity barriers, flashings, weeps, sealants, anchors, and interfaces. Sequence laps and drainage from lower layers upward while preserving movement zones and compatible materials.
Do not conceal barriers, fire stops, flashings, anchors, or cavity closures until continuity and testable interfaces have been inspected and photographed.
Approved submittals, samples, mock-up report, work inspections, adhesion or pull tests, water-test records, surveys, and concealed-work photographs.
Architect, façade engineer, roofing and glazing trades
Install primary supports, plant, risers, ducts, pipes, containment, cables, controls, drainage, insulation, partitions, ceilings, joinery, and finishes. Coordinate sleeves, penetrations, falls, flexible connections, fire stopping, acoustic seals, access panels, maintenance zones, first fix, close-up, and second fix.
Do not close walls, floors, shafts, or ceilings until concealed services and fire stopping are inspected, tested, labelled, photographed, and released.
Test packs, work inspection requests, marked-up drawings, fire-stop register, room checklists, samples, product data, and closed defects.
Services engineers, specialist trades, interior team
Complete pre-functional checks, start-up, flushing, cleaning, testing, adjusting and balancing, controls point-to-point checks, alarm and interlock tests, integrated life-safety scenarios, seasonal tests, inspections, defect closure, operator training, and post-occupancy tuning.
Do not recommend practical completion until critical life-safety tests, statutory approvals, essential commissioning, training, and handover records are complete.
Commissioning plan and results, certificates, as-built drawings, operation manuals, asset register, training records, warranties, and defects log.
Commissioning manager, inspectors, facilities team
Read the building as systems
A detail succeeds only when structure, moisture, air, heat, fire, and services remain coordinated at the same junction.
Where do the forces go?
Gravity and lateral forces must travel through slabs, beams, walls, columns, connections, and foundations into the ground.
How is rain drained and moisture released?
Roofs, falls, laps, flashings, cavities, weeps, membranes, and drains work together to shed water and provide a safe route out.
Where is the airtight line?

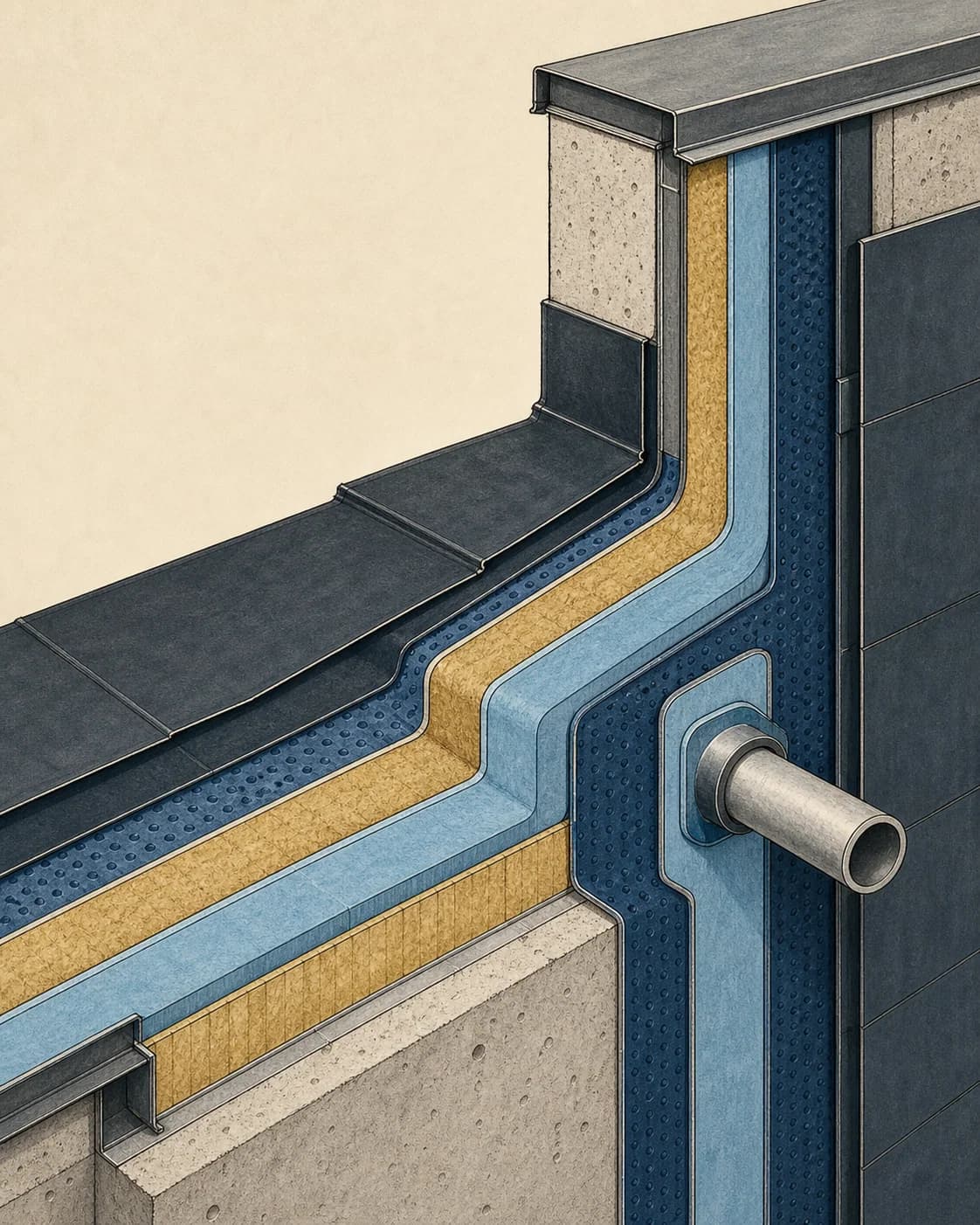

A continuous air barrier limits uncontrolled leakage, improves comfort, and helps the thermal and moisture strategy work.
Does insulation remain continuous?
Insulation slows heat flow. Repeating studs, slab edges, balconies, and metal fixings can bypass it as thermal bridges.
How do people escape and fire remain contained?
Detection, warning, escape routes, compartmentation, structural resistance, smoke control, and fire-service access form one strategy.
Can the systems fit, work, and be maintained?
Power, water, drainage, ventilation, heating, cooling, data, controls, and vertical transport compete for finite space.
Who does what
The job titles vary across countries and contract types. The responsibilities below are the durable part: define, analyse, coordinate, price, make, and verify.
Drawings, spatial strategy, material intent, specifications
How requirements become coherent spaces and buildable details
Structural scheme, calculations, member sizes, connection intent
How loads travel safely to the ground
Mechanical, electrical, public-health and control strategies
How comfort, power, water, ventilation and safety systems perform
Cost plans, quantities, tender analysis, valuations
What the design costs and where financial risk sits
Programme, logistics, method planning, quality records
Who does what, in which sequence, and under what controls
Shop drawings, samples, installations, test records
How design intent becomes safe, accurate physical work
Inspection findings, approvals or compliance records
Whether regulated work meets applicable requirements
Federated models, clash reports, information exchanges
How many disciplines share consistent geometry and data
Choosing a path
spatial ideas, drawing, negotiation, and synthesising many constraints
Explore architecture or design coordination.physics, calculation, evidence, and testing whether things work
Explore structural or building-services engineering.sequencing, teams, logistics, making, and solving problems on site
Explore construction management or a specialist trade.Construction glossary
Start with 8 essentials, search all 80 terms, or filter by the part of the building you are studying.
Sand, gravel, crushed stone, or another granular material used in concrete, mortar, drainage layers, road bases, and compacted fill.
The continuous layer that limits uncontrolled air movement through the enclosure. It may be a membrane, board, coating, or carefully sealed assembly.
A bolt cast, drilled, or bonded into concrete or masonry to connect a base plate, frame, façade support, or piece of equipment.
Records updated to reflect what was actually installed, including locations, changes, product data, and operating information.
Material returned around foundations, walls, pipes, or excavations. It is normally placed in controlled layers and compacted to a specified requirement.
The ability of soil or rock to support imposed foundation pressure without unacceptable shear failure or settlement.
A fixed reference point with a known elevation, used to transfer and check levels across the site.
Building Information Modelling: a process for creating, coordinating, and exchanging structured digital information about a built asset.
The complete index remains one click away.
Terminology, regulations, professional scopes, and accepted construction methods vary by jurisdiction. Use this fieldbook as an educational starting point and check project-specific requirements with qualified local professionals.
Technical basis: OSHA construction glossary, cast-in-place concrete requirements, GSA Commissioning Guide, and DOE envelope guidance.
